SB 721 Inspection and Deck Coating Rebuild for a Rocklin Townhome Community

An owner preparing a 32-unit Rocklin community for sale ordered an SB 721 inspection. The statutory 15% sample turned up moisture behind the fascia, so we inspected all 32 decks — and rebuilt the coating system before the damage reached the framing.

Rocklin, CA 2-day inspection · 10 working days reconstruction Completed February 2026

Project Overview

Location
Rocklin, CA
Property Type
Townhome-style apartment community (32 units)
Timeline
2-day inspection · 10 working days reconstruction
Completed
February 2026

Project at a Glance

32 Decks inspected (sample expanded to 100%)
4 Decks with framing repair
12 Working days on site
0 Units vacated during the work

The Problem

The owner was 90 days from listing the property and wanted a clean SB 721 report in the data room. We started with the statutory 15% sample — five decks, distributed across the community — expecting a routine result on buildings only twelve years old.

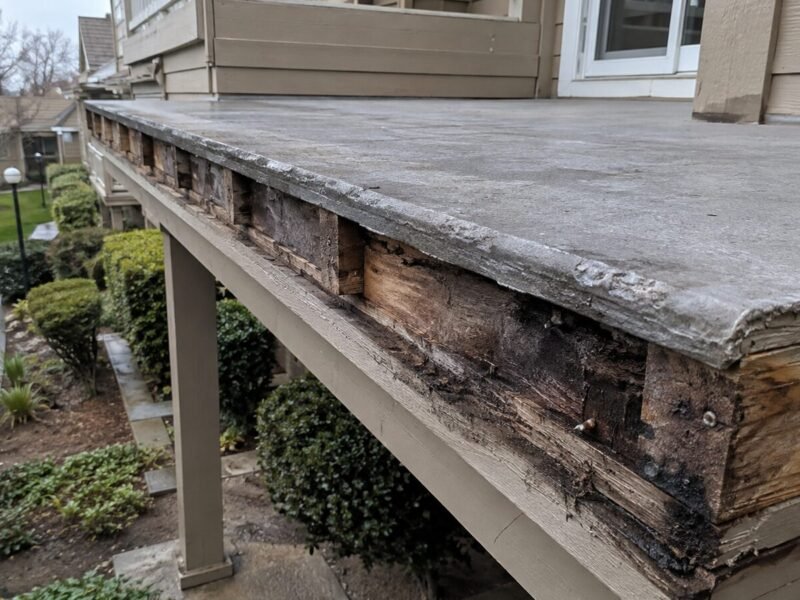

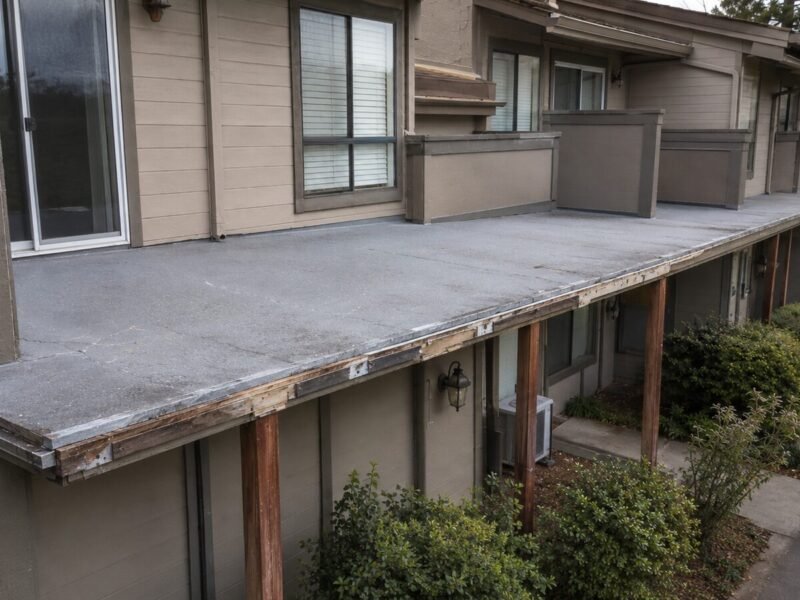

Two of the five had moisture behind the deck edge fascia. The original acrylic coating had chalked and hairline-cracked at the outboard edge, and the edge metal had been installed over the membrane rather than under it, so every rain ran behind the coating instead of off it. We recommended expanding to 100%, and the owner agreed the same day.

The full survey found the same detail on 19 decks and rot at the ledger on four. SB 721 — Health & Safety Code §17973 — gives an owner 120 days from receipt of the report to apply for a permit on non-emergency repairs, and 120 days from permit issuance to finish; a buyer's diligence team reads those dates closely. Our SB 721 inspection service covers the sample, the expansion and the repair under one license.

The Solution

All 32 decks were stripped to the substrate and the plywood checked panel by panel for delamination. Four decks needed framing: rim joists and ledger blocking cut out and replaced in pressure-treated Douglas fir on new Simpson Strong-Tie hardware, with city inspection at each opening.

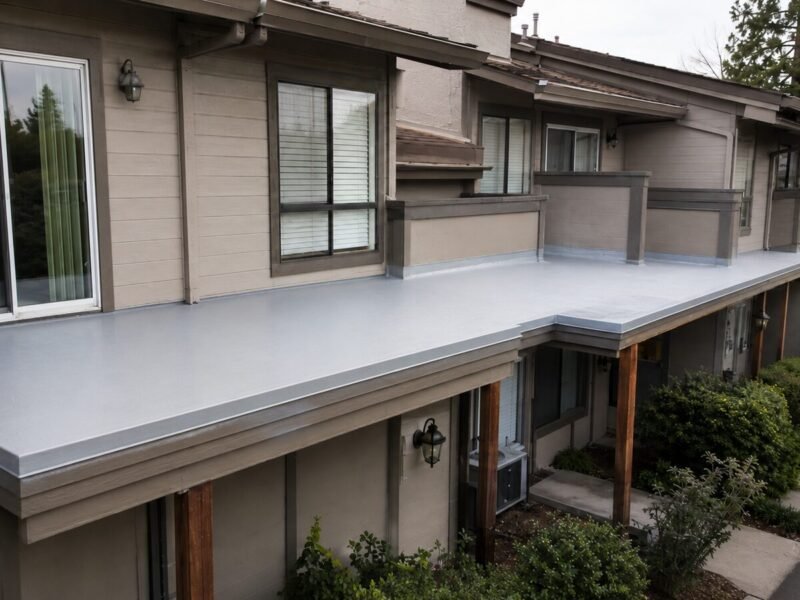

Every deck then received a full Westcoat ALX build-up, with galvanized edge metal set under the membrane and the slope corrected to the drainage edge. Work moved four decks at a time, so no resident lost their entrance for more than a working day, and the finished report went into the listing package with photographs of each deck.

  • SB 721 inspection — 15% sample expanded to 100%
  • Coating removal & substrate assessment
  • Rim joist and ledger replacement on 4 decks
  • Westcoat ALX multi-layer waterproofing (32 decks)

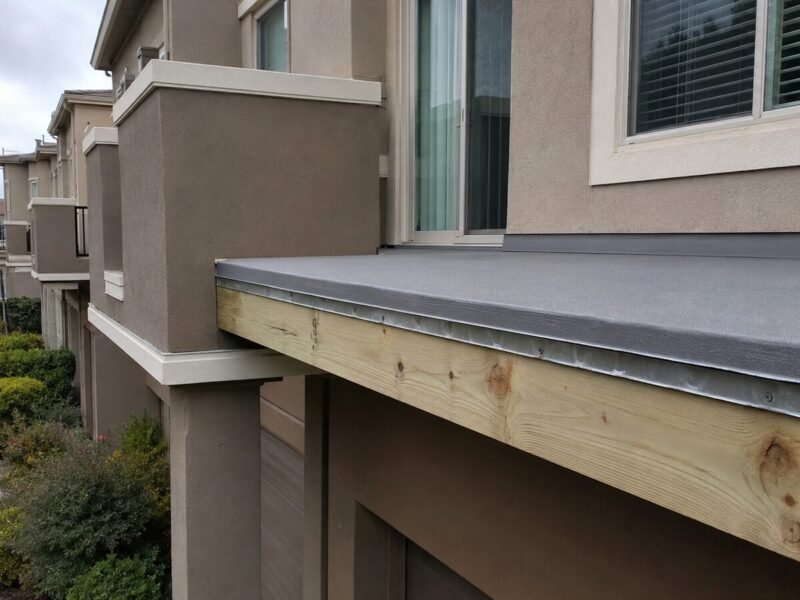

  • Galvanized edge metal reinstalled under the membrane
  • Photo-documented compliance file for the six-year cycle

How the Project Ran

  1. Sample inspection (Day 1)

    Five decks inspected under the statutory 15% sample, with moisture readings and fascia openings; two returned elevated readings behind the edge metal.

  2. Expanded survey (Day 2)

    All remaining decks inspected the following day; 19 showed the same edge-detail failure and four showed structural rot at the ledger.

  3. Framing repairs (Days 3–7)

    Coatings removed, substrate assessed, and rim joists and ledger blocking replaced on the four affected decks with new connectors and permit inspection.

  4. Waterproofing & closeout (Days 8–12)

    Westcoat ALX applied across all 32 decks with corrected slope and re-set edge metal; final report and photo file delivered ahead of the listing.

Materials Used

  • Westcoat ALX system multi-layer walking-deck waterproofing
  • Galvanized deck edge metal set beneath the membrane at the outboard edge
  • Pressure-treated Douglas fir rim joists and ledger blocking
  • Simpson Strong-Tie connectors hangers, straps and fasteners
Final Result

All 32 decks compliant — a clean SB 721 report delivered ahead of the listing date.

They found it on deck number two and told me straight that the sample wasn't going to be the whole story. Better to hear that in October than from a buyer's inspector in February.
— J. Whitlock, Owner (32-unit community, Rocklin)
